A beach wheelchair program is ready to open when a visitor can find the right entrance, meet the agreed assistance, use the planned route and return the equipment to someone who can check it. Design the project around that complete visit. A purchase order can specify a chair and spare parts. The operator also needs a usable route, a place to store and prepare the equipment, and staff who can carry out each handover.
Begin the project with one deliverable that the procurement and operations teams can both recognise. For example, a first phase might provide assisted seated travel from a named collection desk to a shaded beach viewing area during staffed hours. That description identifies an equipment job, a destination and a staffing commitment. A later water-access service would need its own assessment and handover.
Survey the journey before specifying the equipment
A site audit identifies the physical path a user must take from the parking area to the water’s edge. For your project, survey as far as the destination you actually propose to serve. Walk it in both directions. Include the route from equipment storage to the collection point, the agreed place for transfers and the space to return a visitor’s regular mobility device.
Measure the narrowest usable opening, relevant changes in level and the turns at the collection point. Describe the transition from pavement, ramp or mat to sand and the conditions when the survey was made. Mark any segment that needs site work or a separate technical decision. Invite prospective users and staff to point out barriers the project team has missed, including practical questions about waiting, private assistance and how to reach a member of staff.

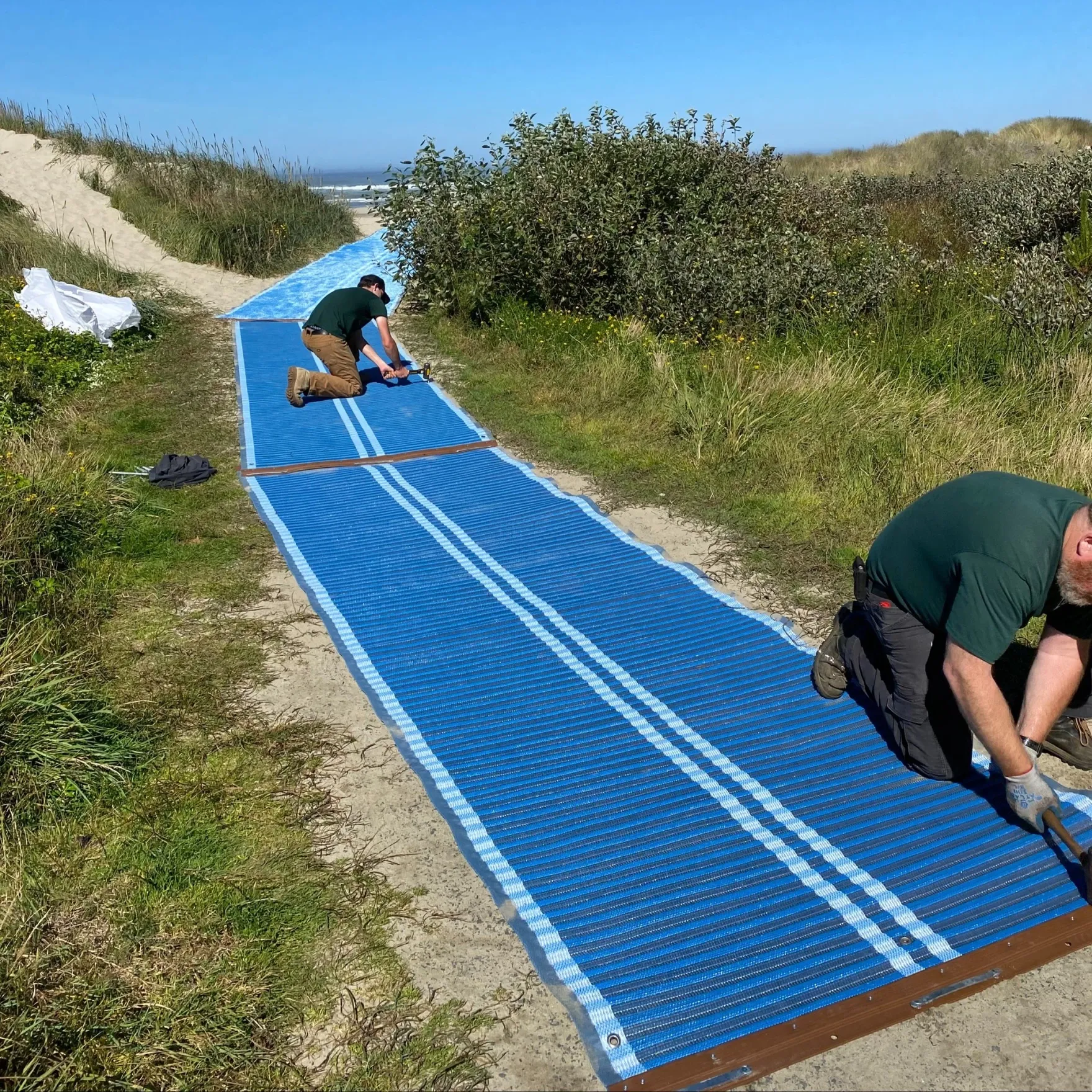

If the route needs matting, specify its start and end connections along with the required length. A completed delivery of mat sections still leaves the site team responsible for reviewing the installed route and its maintenance arrangements. Connecting beach access mats and ramps
Turn the chosen service into a supply schedule
Identify the role and configuration for each item before comparing quotations. A seated land service needs a chair, route and assistance suitable for its visitors. A walking-support service requires a separate device and fit discussion. Count mat sections from the measured layout and reserve storage and preparation space for the equipment the team will actually issue. Choosing a chair and mat mix
For a land service using the AY-ST-V2.0 high-back chair, page 2 of its manual lists overall dimensions of 120 cm long, 110 cm wide and 122 cm high. Suppose the store has a 100 cm clear doorway. The chair’s listed assembled width rules out rolling it straight through that doorway. Check an alternative storage position or a supplier-approved handling configuration before allocating the unit to that store. AY-ST-V2.0 manual, page 2
For a proposed supervised shallow-water service, the AY-ST-V1.0 is one configuration a buyer can specify. The corrected manual identifies an aluminium-alloy frame, three inflatable PVC wheels, two detachable inflatable PVC armrests and a three-position backrest. Ask the supplier to identify the ordered assemblies, the applicable manual and the separately priced service parts. The operator must also be able to provide the model’s controlled calm-water setting, trained supervision and stable attendant footing. AY-ST-V1.0 component drawings · Manufacturer’s operating scope
Put training, packing, delivery to the agreed address, spare parts and technical support on separate quotation lines where they are needed. Have the buyer record which party undertakes each task and what the site must supply.
Give receiving staff an acceptance record they can use
Send the accepted configuration and packing list to the receiving team before the shipment arrives. They need to distinguish a missing assembly from one packed in another carton, and transport damage from a condition found during later trials. Keep photographs with the model, asset identifier and package reference.
| Deliverable | What the receiving or operating lead should be able to show |
|---|---|
| Ordered equipment | Delivered model and component set match the purchase record, with discrepancies identified by unit. |
| Instructions and parts | The correct instructions and service references are available where staff will set up and maintain the equipment. |
| Site works | The intended approach, transitions and endpoint have been checked in their installed configuration. |
| Readiness for use | Required assembly and functional checks are complete, and any held item is visibly unavailable. |
| Support after delivery | Staff have an agreed way to report defects, obtain approved parts and verify a repair. |
An incomplete chair should have an asset record and a clear status even if the supplier has already sent the missing part. Mark the unit ready after its authorised fitting and checks are complete. If a route detail remains unfinished, the site lead should decide what service, if any, can open within the portion already accepted.
Rehearse one complete booking with the launch team
Ask the desk to take a practice enquiry. Can staff describe the route, equipment and assistance accurately? Have the equipment team retrieve the correct unit, perform its assigned checks and prepare the collection point. Rehearse the agreed handover with the people responsible for it. Individual fitting, user training and follow-up belong with appropriately trained personnel. WHO training in priority assistive products
Continue the rehearsal through return. Name the person who receives the unit, records a concern raised by the visitor and places equipment awaiting cleaning or repair in the correct area. Try one specific interruption. If the chair develops a suspected wheel fault at collection, can the desk remove that asset from the schedule and contact the next booking? Use the same phone, records and staff cover the team will have during opening hours.
Hand the service over to the people who will run it
At opening, give the duty lead the dated route plan, list of released assets, operating instructions, staff contacts, visitor wording and any outstanding works with their owners. Agree how staff will announce a closure or a change of endpoint. If only the land service has opened, the booking desk should describe that exact service.
After the first operating period, review missed requests by reason. A queue caused by simultaneous returns calls for different action from a queue caused by a chair awaiting parts. Compare what visitors asked for, what the team could provide and what stopped the other visits. Those records give the project sponsor a basis for deciding whether to change staffing, improve the route or buy another unit.
